Travis Country Water-Wise Front Yard Transformation

Priorities: – Water Conservation – Elderly-Accessible Design – Stormwater ManagementNative Plant Integration
Challenges: – Large Turf Area Removal – Drainage Issues – Accessibility Needs – Site Topography
Solutions: – Strategic Water Management – Accessible Pathways – Native Plant Selection – Functional Hardscaping

This residential transformation centered on two key objectives: creating a water-conscious landscape and ensuring accessibility for the elderly homeowner. The project qualified for the City of Austin’s WaterWise Landscape Rebate Program, demonstrating its alignment with local conservation initiatives.

The first major task involved removing 1,200 square feet of traditional turf, replacing it with a thoughtfully designed landscape that manages water more effectively. A carefully engineered swale system now captures and redirects water from downspouts, while strategically placed berms add visual interest and create optimal planting conditions.

house before major landscaping project

Accessibility was paramount in the design. We installed a stabilized granite pathway, providing a secure route from the seating patio to the yard’s corner. This surface offers reliable footing while maintaining the natural aesthetic of the space.

To enhance the landscape’s functionality and visual appeal, we incorporated multiple hardscape elements. Custom steel edging creates a clean transition between the remaining grass and the transformed area. Carefully placed boulders serve dual purposes – as informal seating and as artistic elements that ground the design.

maas verde workers adding soil

A dry creek bed serves as both a decorative feature and a functional drainage solution, directing water flow toward the side yard. The addition of juniper log edging around the mulched play area creates a natural boundary while complementing the overall design aesthetic.

The planting plan focused on shade-tolerant native species, selected for their ability to thrive in local conditions while requiring minimal water. These plants, combined with proper soil preparation and mulching, create a sustainable landscape that will mature beautifully while conserving water resources.

front yard with new plants and granite pathway

This transformation demonstrates how functional needs – water conservation, accessibility, and stormwater management – can be met while creating an aesthetically pleasing, sustainable landscape that serves both the homeowner and the environment.

Balmorhea State Park Comprehensive Irrigation Repair

Priorities: Troubleshoot Prolonged Irrigation System FailureChallenges: Multiple Failed Prior Attempts – No Plan Documents – One Urgent ScopeSolutions: Trace Underground Faults – Expedite with Key Equipment

Maas Verde received an initial, urgent call from a nonprofit working to donate a handful of trees to West Texas’ Balmorhea State Park.

The organization needed a fast irrigation repair for an upcoming event held in conjunction with the donation. The planted trees were wilting in the desert landscape, partly because the park’s irrigation system had not functioned since before the current park supervisor’s two-year tenure.

Maas Verde had four days to find a solution for the expedited work order. After that, the team would lean into a repair of the park’s entire system — which tunnels under the park’s turf, asphalt, sidewalks, and even canals for thousands of feet.

(Read the full story here. Or stay on this page for a scope-focused report.)

balmorhea state park pool, overhead viewBalmorhea State Park, home to the world’s largest spring-fed swimming pool. Photo: Wiki Commons

First Mobilization, Scope, and Challenges

Our technicians loaded up material, troubleshooting tools, and digging equipment at our Austin headquarters and moved out via I-10.

When they arrived at the park, superintendent Torrey Bonham provided an orientation that was as complete as possible.

Despite Bonham’s substantial efforts, he could not possibly collect all the relevant information, which had degraded throughout previous administrations. Multiple prior contractors had worked on various pieces of the 12-zone system, but none had resolved its functional issues.

Maas Verde first determined the system needed a new controller, and that an attempted line to irrigate the new trees had failed. The team determined that rather than remediating the existing equipment, installing a new line was the only viable option.

an irrigation dig site

But the system’s large scale forced us to source components from the nearest irrigation supplier, 90 minutes away in Odessa. The 130 PSI pump pushed water through pipe up to 4” — on scale, the network rivals golf courses.

The team logged overtime daily to complete the first install on schedule. The only way to expedite the process was to trench and dig with a mini skid steer and excavator.

trenching equipment and a finished trench at the park

Once Maas Verde successfully added the zone, the full system remediation began.

Full System Diagnostic and Repair

The team could only locate underground faults one at a time. Technicians could only locate the next electrical failure or pipe leak by tracing it downstream from the last one.

Scrambled componentry representing the layers of prior installs and attempts made the work more puzzling. An emergency sewer repair was the unexpected cause of one severed wire; the tree-planting subcontractor had destroyed several feet of pipe with an excavator but done nothing to report it; miswired solenoids had shorted out and no longer operated.

a large, buried irrigation valveBalmorhea’s irrigation system was big, sprawling, and convoluted.

Resolving breakages demanded using a ground fault locator and other specialty tools, but deep landscape experience was critical to success. Reading subtle surface conditions like linear swales and concrete repairs helped the team decide where and how to excavate safely and effectively.

The team solved each fault as it surfaced. Through this process, we began mapping the system and eventually developed an understanding of its full scope and operation.

pumping overflow out of an excavated hole; wires inside a valve box

Finally, Maas Verde excavated an old valve buried in an obscure location below several inches of natural turf. This hidden component proved to be the last missing link in the system. Our technicians incorporated it into the system, confirmed each zone operated from the controller, and concluded the project.

     View this post on Instagram



A post shared by Maas Verde Landscape Restoration (@maasverde_atx)

Streambank Stabilization on Gulf Coast Watershed

Priorities: Stabilize Creek Bank – Bioengineered Solution – Army Corps of Engineers ComplianceChallenges: Objective Site Hazards – Downstream Impact – Heavy Equipment Safety and environmental concerns – Heavy Rain Events During Implementation –Solutions: Mission-Aligned Mindset – Network with Proven/Reliable Subcontractors

Two segments of a tributary of the Colorado River near the Texas coast required stabilization due to increasing erosion concerns. The scope of work existed under a recent Army Corps of Engineers infrastructure project that relied on the creek for functional drainage and stability.

A state government agency and an international engineering firm identified that the two segments, separated along the waterway by about a mile, were important drainage zones. Flood events are common in this watershed. And if the creek overflowed its banks significantly during these events, it could undermine the new infrastructure project at these two critical points.

The prescribed solution was bioengineered. In concept, the project would install riprap toes as foundations for soil lifts along 1,100 linear feet of the existing streambed. Technicians would harvest 32,000+ live willow cuttings from a nearby location and install them in the lift structure for long-term soil stabilization.

The project’s designers estimated it would take six months to complete. Maas Verde earned the contract, then vetted and recruited subcontractors, and completed the project one month ahead of schedule, causing zero safety or environmental reportable incidents — despite experiencing two flood events on site during mobilization.

an excavator works on a streambe stabilization project

A project debrief follows.

Scope

Key Concept: Encapsulated Soil Lift Construction

Implementation demanded multiple scopes of work, with extensive earthwork at the core of the project.

First, each work site required conditioning and stabilization for safe operation of equipment up to 40,000 lb. excavators and tk dump trucks. Site preparation also required dewatering and diverting the creek in both areas. At one site, a 45-foot-long, 9-foot diameter culvert installed decades prior to the Army Corps of Engineers’ involvement would need to be removed.

removing a large culvert

Reshaping and regrading the streambanks followed. Installation of riprap check dams and toes to spec took place in conjunction with soil lift construction, as operators manipulated excavators closely alongside workers with hand tools. Willow harvesting and install occurred simultaneously.

All cuttings and soil lifts needed irrigation to succeed, which also required a system design. Finally, each site needed restoration from impact. Specifications dictated reseeding five acres of compacted soil, then monitoring both sites to ensure success rate of selected species for one year.

Based several hours away in Austin, Maas Verde would also need to mobilize and demobilize from the site.

Maas Verde Leads Critical Contract Change

Key Concept: Expert Recommendation on Flawed Plan

The clients first issued their request for proposal (RFP) of the streambank stabilization project in January, 2021.

Maas Verde surveyed the materials and scope and recognized a critical issue with the willow cutting timeline.

Maas Verde knew the cuttings needed to be harvested while the plants were dormant. Failure was guaranteed if any contractor took the cuttings while the plants were active. Only one location within a 100-mile radius harbored willows, so it represented the only solution.

The initial RFP specified Feb. 4 as the mobilization date. Maas Verde’s president and founder Ted Maas knew from his Master Naturalist training that willows in the region stay dormant until mid-March.

Targeting this critical date while drafting a schedule for the project, Maas realized the harvesting window was too tight. He advised the project designers this was the case. The decision effectively removed Maas Verde from the bidding process, regardless of costs sunk in research and development toward responding to the RFP.

However, the project designers reviewed Maas’ findings and realized he was correct. They then bumped the RFP date to August.

When it arrived, Maas Verde picked it back up, incorporating its previous progress. Maas Verde earned the contract and prepared to mobilize on the new date — Nov. 1.

Site Visit and Subcontractor Recruitment

Key Concept: Safety First

Maas Verde visited the job sites throughout August and September. Project managers planned efficient material drop-off areas and evaluated the site for safety and necessary modifications. One high priority involved working around the access road, which had no construction or drainage structures and would not support heavy equipment or material delivery during any rain event. Another key task was to create stable pads for excavators along the streambed.

Maas evaluated subcontractor candidates with safety as a primary concern. Equipment operators for a small local company stood out and earned a contract. Maas Verde also signed a contractor from outside the state with strong soil lift construction experience.

Building sound relationships with nearby equipment dealers would also factor into Maas Verde’s success.

“For most companies, it’s a long way to travel,” Maas said, noting multiple contractors from Houston and Austin visited the site but eventually balked. “And with an environmentally sensitive work site that’s also a safety challenge, it’s important to hire the right people.”

Mobilization, Site Prep, Dewatering

Key Concept: Take the Time to Create Stable Work Sites

Maas Verde mobilized to the job site as planned on Nov. 1.

Riprap deliveries arrived steadily throughout the month, totaling 1,300 tons. Maas Verde prepared the site by setting up its mobile office, installing silt fence, and preparing to clear and grub key areas.

Maas Verde conducted dewatering and diversion of the creek in-house. The team’s dam solution utilized steel I-beams and timbers. After constructing and placing the dam, the team installed a diesel-fueled pump with float valves to regulate water levels upstream and displace overflow downstream.

a dam for dewatering and creek diversion

The dam’s modular construction later facilitated fast rebuilds after both flood events.

As dewatering proceeded, Maas Verde identified build sites for heavy equipment work benches. Many of these sites exhibited a highly unstable soil structure: Clay topsoil several feet deep slid on top of a sandy layer loose enough to promote measurable water flow. Another clay bed began about 12 feet down.

The soil was essentially “upside down.” Maas Verde knew that operating equipment on the sand layer would create a hazard to every worker on site, and performed necessary remediation. Operators cut the sandy layer out to create a wide pit at every bench site, then replaced it with a stable clay mixture. Timber mats were placed on top to distribute weight and create reliable, regular surfaces.

Construction

Key Concept: Sequence Workflow to Keep Crews Tasked

The team first shaped and excavated an existing ditch with six 24” pipe culverts that drained stormwater off roads from a higher elevation. Backfilling it with riprap to promote functioning drainage, Maas Verde then started soil lift construction in the main channel.

Sequencing multiple work scopes across operator and hand tool crews was key to efficiency. Earthwork like shaping and grading came first, then riprap placement (each process involves excavator work only). After that, hand crews worked alongside operators in soil lift construction to lay fabric, pour soil, close the structure, and plant it with willow cuttings.

“As we’re doing earthwork and placing riprap in one location, we’re rolling out our fabric for our encapsulated lifts in another — to keep moving. It’s an orchestra, and the general contractor’s job is to conduct it,” Maas explained. “What do we need to be doing right now to set us up for the next two days — the next week — and stay on the critical path?”

Maas Verde was committed to taking any extra steps critical to safety, but also knew unpredictable weather could cause time sinks. So while the work was moving forward, it “needed to be seamless,” as Maas put it.

Floods Test Project Infrastructure, Methodology

Key Concept: Do Not Leave a Job Site Vulnerable to Severe Weather

Maas Verde had made significant progress at the first work location when two floods ripped through the creekbed.

The early January events tore out the temporary dam we had installed (which was expected, based on the flow rate). But the I-beam and timber construction allowed Maas Verde to reconstruct it quickly and efficiently. Dewatering the work area again, the team found its work still fundamentally intact.

That reflected the attention to detail Maas Verde paid to the project phases. Instead of partially-constructed soil lifts or unsecured work benches, the surging waters plowed through a job site that — though not yet complete — had more finished structures than partial ones.

“Engineers had urged us to ensure our work was ‘armored’ whenever the forecast got marginal,” Maas said. “We kept that advice in mind at the job site, and it became invaluable.”

Management rallied subcontractors to stay on task through work schedules that became stringent. Once the dam was reinstalled and the site was workable again, Maas Verde moved fast to minimize progress lost in any further flooding. Morale and safety came into sharper focus as work hours expanded.

The second flood did occur — just two weeks later. And with a further optimized dam design, Maas Verde needed just three days to remediate damage to the site and move forward to completion.

Unstable forecasts created more pressure as Maas Verde transitioned to jobsite two. (One prior contractor had attempted to implement a stabilization project there years before, but a flood ruined their progress and they abandoned the job.)

Systems experience and a simpler jobsite made fast work there. Maas Verde needed just over two weeks to shore up the site and report substantial completion during the first week of February.

Irrigation, Site Restoration, Monitoring Challenges

Key Concept: Follow Through

Maas Verde designed and installed a gravity-fed, 5,000-gallon PVC irrigation system to ensure the cuttings rooted and stabilized the soil lifts. Next, the team decompacted soil in all heavily-impacted areas and moved on to seeding a specified hillside adjacent to jobsite one.

Maas Verde would need to return to the jobsite periodically for one year to monitor success of the grass seed and soil lifts.

Unfortunately, both threatened to fail at first. A spring drought followed the winter floods, and the hillside grass seed (a mix of native grasses and Bermuda) did not propagate. And while the irrigated willows rooted aggressively to the soil lifts, an infestation of dodder vine threatened to choke out the trees at jobsite two.

Maas Verde initiated their vegetation management plan by first addressing the parasitic vine. As part of their ecological approach to vegetation control, they removed it by hand instead of spraying, preserving the site’s ecological integrity.  Volunteer pollinator plants grew below the willows and Maas Verde realized the site now acted as a biodiverse, native habitat.

plants in a streambed alongside a roadwayBy fall 2023, willows in the streambed (middle background) had grown to 25 feet tall at a 6″ caliper.

“Because of our watering efforts, these willows were thriving, and so were these understory plants. And where there would be a stem getting choked out by dodder, there would also be a healthy sprout below it. We knew it could all come back, which was why we didn’t spray it,” Maas said.

Seeding followed, but not immediately. Because the seed had died even with agricultural-grade sprinkler irrigation, Maas Verde recommended re-addressing it in September. The solution to first spread compost, then seed it with the same grasses, succeeded.

Maas Verde now confirms completion of all project phases and zero reportable safety or environmental issues.

Hill Country Conservancy Violet Crown Trail Butterfly Garden

Project Description

The Violet Crown Trail is a first-of-its-kind project in Central Texas. A trail system that will eventually link Zilker Park with Hays County, planning began in 2006. Called “the first regional trail system” in the region, it now covers 13 miles from Zilker Park to the Lady Bird Johnson Wildflower Center.

Maas Verde worked as a subcontractor to reclaim an area used for construction staging during trail installation. Scope included rehabilitating the disturbed area by decompacting and amending the soil, planting a native seed mix, and setting up a temporary irrigation system to encourage seed establishment.

We also designed and installed a butterfly garden, using native plants and boulders. The temporary irrigation helped the plantings receive the water they required to become established. This was fed by a 600-gallon water drum, which required complex calculations to construct above-ground.

Project Details

Skills Needed:

HardscapingIrrigationLandscape DesignLandscape InstallationNative Ecology ExpertiseTrail Design

Pease Park Retaining Wall

Project Description:

The goal of the Pease Park Conservancy is for Pease Park to be known as an accessible urban green space for play, adventure, and connectivity, where land stewardship, environmental innovation, and inclusive programming embrace the community’s history and inspire its future. Maas Verde Landscape Restoration was engaged to construct a retaining wall adjacent to North Lamar in furtherance of that vision.

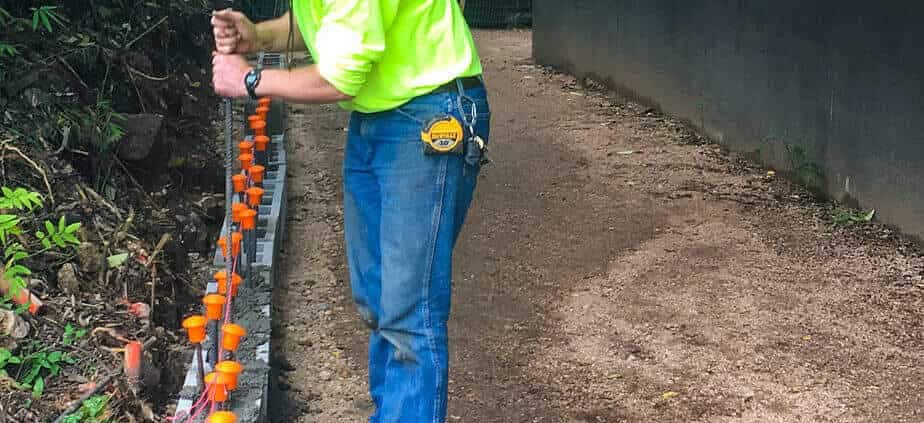

Safety is always a priority at Maas Verde, but because this construction took place in a public park with public access, it became a highlight of the project for both workers and parkgoers. Using anchored cinderblocks as the structural base, our team constructed a secure retaining wall reinforced by rebar and finished with natural limestone. We worked with stakeholders in the Pease Park Conservancy (a 501(c)3 non-profit) and the City of Austin to ensure that the project exceeded expectations.
